Multi-asset energy sites in Europe face a growing coordination challenge. As solar PV, battery energy storage systems (BESS), and other generation assets share a common point of connection, the power plant controller (PPC) provides the plant-level control layer needed to coordinate their behaviour and manage active and reactive power at the grid connection point.

This guide explains how to integrate a PPC on multi-asset sites in Europe in 2026: what is changing this year, how national grid codes shape controller requirements, how to define the control architecture, and the integration process itself, from grid connection studies to post-commissioning updates.

1. Key Takeaways

  • A power plant controller (PPC) coordinates controllable plant assets such as inverters, BESS, and generators at the point of connection to meet European grid-code obligations.
  • 2026 is a transition year: the revised EU network code for generators (NC RfG 2.0) was published in draft by the European Commission in July 2026, with new grid-forming requirements and explicit rules for storage.
  • European TSOs and DSOs enforce market-specific reactive power, frequency response, and active power curtailment requirements, so compliance is never transferable between countries by default.
  • Multi-asset sites need a control architecture defined early to avoid duplication, cost overruns, and commissioning delays.
  • PPC integration is a multi-stage process (studies, FAT, commissioning, compliance testing, lifecycle updates), not a single commissioning event.

2. What Is a Power Plant Controller?

A power plant controller (PPC) is the central control system that manages the electrical behaviour of a generation facility at its point of connection with the grid. On a multi-asset site combining solar PV, BESS and generators, it sits between the TSO or DSO and every controllable asset and depending on the plant architecture, the PPC receives plant-level active and reactive power targets directly or through an interface such as a substation RTU or gateway. It coordinates the assets included in the project design, within their technical operating limits.

The PPC receives plant-level active and reactive power targets and translates them into coordinated commands for each supported asset. This is what allows a hybrid plant to behave as a single, dispatchable unit at the point of connection, rather than a collection of independent devices whose aggregate behaviour nobody controls.

European energy policy and grid-code frameworks are accelerating the deployment of hybrid power plants that combine solar, storage, and conventional generation on a single site. For industrial and commercial (C&I) energy managers, this trend introduces a fundamental technical requirement: a control architecture that can manage all assets as one coordinated system.

The EU network code on Requirements for Generators (NC RfG, Regulation (EU) 2016/631) defines the baseline technical capabilities that generation facilities must demonstrate at the point of connection. Each member state then implements national grid codes that add market-specific requirements on top of this baseline.

A PPC is an important part of the plant-level control architecture used to implement these requirements in real time. Grid-code compliance is not a commissioning checkbox. For projects with PPA contracts spanning 20 to 25 years, compliance is an ongoing obligation that must be maintained throughout the full lifecycle of the plant.

4. What Changes for PPC Integration in 2026?

Three shifts make 2026 a pivotal year for anyone specifying a PPC in Europe: the revision of the generator connection code, rising grid-forming expectations for storage, and the fact that hybrid, co-located sites are becoming the default project configuration.

Evolving European Grid Code Requirements (NC RfG 2.0)

The European Commission published a draft revision of the Network Code on Requirements for Generators (NC RfG) on 8 July 2026 and held a public consultation until 25 August 2026. The draft proposes requirements for electricity storage and grid-forming capabilities. Until the revised code is formally adopted and enters into force, these remain proposed requirements rather than binding rules.

Two changes matter directly for PPC integration. The scope extends beyond generating units to set specific requirements for electricity storage and vehicle-to-grid technologies. And the draft proposes to shorten the national implementation period from two years to nine months, a point that German stakeholders such as VDE FNN have contested. If maintained, national grid codes could change much faster than in the first RfG cycle.

For project developers, the practical consequence is simple: a PPC specified in 2026 must be able to absorb new control functions and new settings through configuration and firmware updates, without a hardware change.

Rising Grid-Forming Expectations for BESS

The NC RfG 2.0 draft introduces a dedicated article on grid-forming capabilities, with non-exhaustive requirements for non-synchronous generating and storage units, such as synthetic inertia and voltage-source behaviour. ENTSO-E published a Phase II technical report on grid-forming requirements in November 2025 and must issue implementation guidance within six months of the code entering into force.

Some TSOs are not waiting. In the Netherlands, system operators have proposed national grid-forming requirements for transmission-connected storage, explicitly citing the delay of NC RfG 2.0. For BESS projects, the PPC must therefore coordinate with PCS units that may operate in grid-forming mode, and its control loops must be tuned so that plant-level setpoints do not fight the fast, inverter-level grid-forming response.

Hybrid and Co-Located Sites Becoming the Norm

Adding storage to solar, whether on greenfield hybrid sites or as a retrofit on existing plants, is now a mainstream project model in Europe. Each new asset type increases the number of devices, protocols and control objectives that the PPC must reconcile under a single connection agreement. As highlighted in ESS News’ coverage of the Kiwa PI Berlin analysis, delaying these control decisions has a direct CAPEX impact.

5. How Do European Grid Codes Shape PPC Requirements?

European grid codes impose a range of technical requirements on generation facilities, and each national market interprets and extends these requirements differently. What a French TSO requires in terms of reactive power capability is different from what is mandated in Spain or Germany.

Active Power Control, Curtailment and Frequency Response

TSOs across Europe require generation facilities to reduce active power output in response to grid frequency deviations or direct curtailment signals. The PPC interprets the applicable plant-level target and distributes feasible active power commands across the available controlled assets according to the configured control strategy.

For plants integrating BESS, active power control must respect the available PCS power, BESS charge and discharge envelope, state of charge, and other equipment operating limits. The applicable response time and control performance criteria depend on the project and its governing grid requirement.

Reactive Power and Voltage Control

Reactive power management is a core grid-code requirement in virtually every European market. The PPC may manage reactive power through functions such as power factor control, Q setpoint control, Q(U) characteristics and voltage control at the point of connection, according to the project-specific control strategy and grid requirements.

Required capability curves, control modes and response times differ from one country to another (see the country table below). The PPC must support the modes required by the relevant operator and switch between them on TSO or DSO instruction.

TSO/DSO Interface and Setpoint Communication

The PPC receives setpoints and returns plant status to the grid operator, either directly or through a substation RTU or gateway. The required protocol and data model are set by the operator: IEC 61850 is increasingly used for substation automation, IEC 60870-5-104 remains widespread for TSO telecontrol, and Modbus are still found on many sites. A single site may need to interface with both a TSO and a DSO, each with its own protocol. Protocol selection is covered in detail in the interoperability section below.

Country-by-Country Differences

The table below summarises the main national references a PPC integrator will meet in the selected European markets. It is a starting point for scoping, not a substitute for the connection agreement and the operator’s own technical documentation.

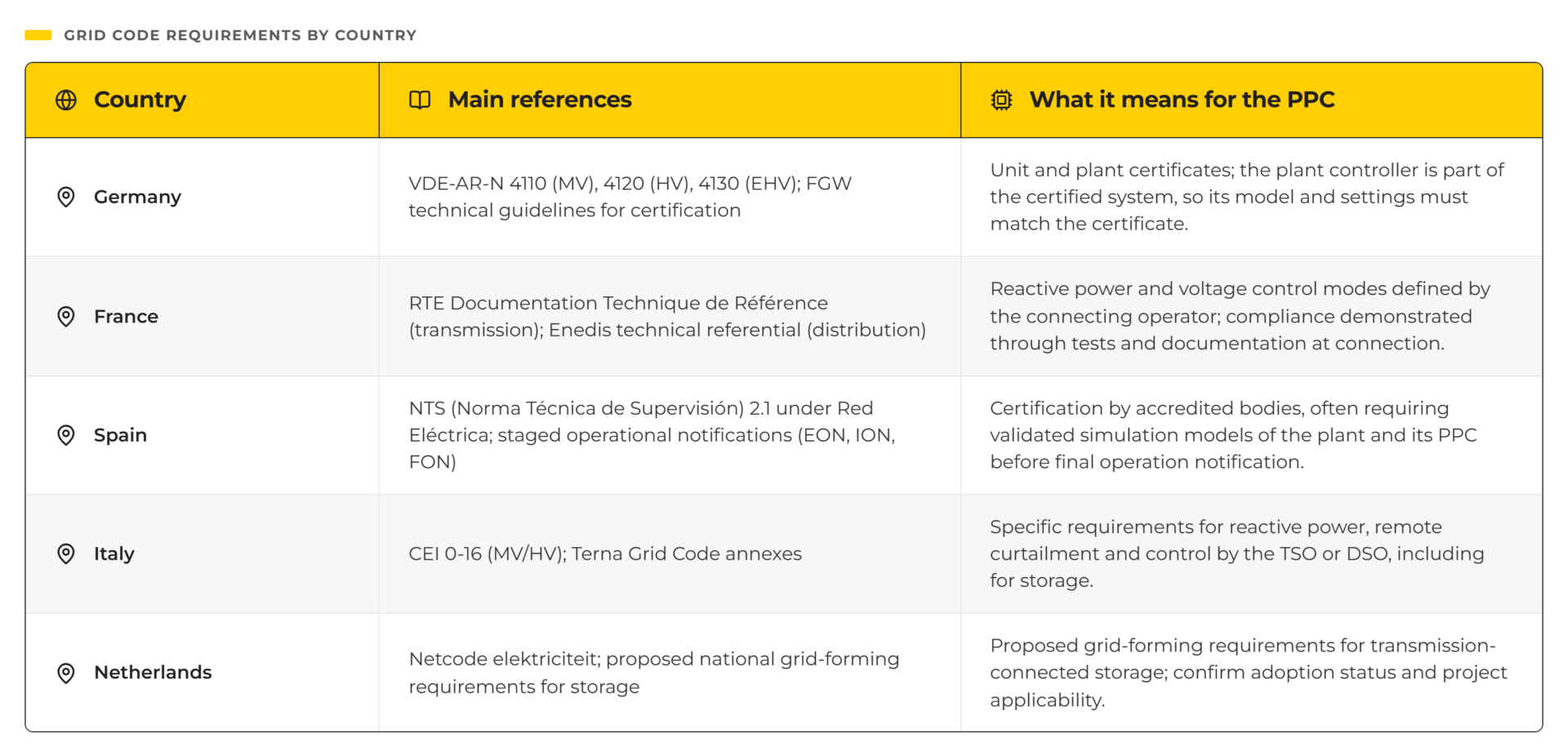

elum-tableau-5-grid-codes

6. How to Define the Control Architecture for Multi-Asset Sites

Defining the control architecture early in the project development process is a strategic decision, not a task to defer until the EPC procurement phase. According to a 2026 analysis by Kiwa PI Berlin, postponing control architecture decisions can increase project CAPEX by around 3%, with a PPC and SCADA package typically costing between €300,000 and €600,000 depending on functionality.

Single PPC vs. Hierarchical Configurations

For a greenfield hybrid plant, a centralized plant-level PPC can provide a direct control architecture when the selected assets and interfaces are designed to operate under a common plant-control strategy. This approach minimises communication latency and reduces the risk of conflicting setpoints between subsystems.

For brownfield projects where storage is being added to an existing solar facility, a hierarchical configuration may be appropriate depending on the existing controllers, interfaces and project control philosophy. A dedicated BESS controller operates under a higher-level plant controller, which aggregates the behaviour of both the original and new assets.

Roles of EMS, PPC and SCADA

The energy management system (EMS), PPC, and SCADA platform each serve distinct functions, but their boundaries must be clearly defined before procurement begins. In a typical architecture, an EMS handles higher-level optimisation and scheduling, while the PPC manages plant-level active and reactive power control. SCADA provides monitoring, data acquisition, HMI, alarms, and operational supervision. The exact boundaries between these systems depend on the project architecture.

For multi-asset sites, SCADA must aggregate data from all connected assets (inverters, BESS, generators, meters and weather stations) into a unified view, giving operators the measurements they need for supervision and troubleshooting over the plant’s operating life. ePowerSCADA provides plant-level monitoring and control through an HMI, while ePowerMonitor provides remote data visualisation for multi-energy and multi-site monitoring. Both can complement ePowerControl PPC depending on the project architecture.

Overlap between these systems, particularly when an EPC contractor and a BESS supplier each include similar control solutions in their scope of work, can result in duplication and increased costs. Defining these boundaries at the specification stage avoids this risk.

Coordinating PV and BESS Dispatch

On hybrid sites, battery dispatch must be coordinated with PV production, grid setpoints and site loads. Depending on the architecture, the EMS may calculate schedules for peak shaving, self-consumption or grid services, while the PPC executes plant-level targets and constraints. The dispatch strategy must respect the PCS limits, battery SoC limits and applicable BMS constraints.

This functionality is particularly relevant for C&I sites where demand charges can represent 30 to 70 percent of a commercial electricity bill. A facility that uses a battery to cap its monthly peak demand at, say, 500 kW instead of 650 kW can reduce its demand charge proportionally.

Grid-Following vs. Grid-Forming: Implications for the PPC

Most grid-connected solar and BESS inverters in Europe operate in grid-following mode: they synchronise with the voltage and frequency set by the grid, and the PPC dispatches active and reactive power around them. Grid-forming inverters instead create their own voltage and frequency reference, which is why European requirements are moving towards them for storage.

For the PPC, this changes three things: control loops must be coordinated with faster inverter-level responses, the controller must handle mode settings and transitions defined by the operator, and simulation models used in grid studies must represent grid-forming behaviour. For a full explanation of both modes, including islanded and weak-grid scenarios, see our guide Grid-Forming vs Grid-Following: What’s the Difference?

7. Interoperability and Communication Protocols

Interoperability is one of the key technical attributes of a PPC for multi-asset sites. A controller that cannot communicate with the specific inverter, PCS, or BESS models on your site will require custom driver development, extending commissioning timelines and increasing project risk.

Key Protocols (IEC 61850, IEC 60870-5-104, Modbus TCP, DNP3)

Two interfaces must be considered separately. Upstream, towards the grid operator, the protocol is imposed: IEC 61850 and IEC 60870-5-104 dominate at substation and TSO level, with DNP3 in some contexts. Downstream, towards the plant assets, Modbus TCP, Modbus RTU and SunSpec Modbus remain the common language of inverters, PCS units and meters.

Multi-asset sites may need to support multiple communication protocols simultaneously, and a controller limited to Modbus may need a gateway if the operator mandates IEC 61850 or IEC 60870-5-104. Check every required interface before procurement.

Vendor-Agnostic Architecture for Mixed-Asset Sites

A vendor-agnostic architecture means you are not locked into a single asset manufacturer’s ecosystem. This flexibility is particularly relevant for European industrial sites where procurement decisions may evolve over the project lifecycle as new asset types (EV chargers, hydrogen electrolysers) are added.

Elum Energy’s ePowerControl PPC provides multi-brand interoperability with a large number of plant devices. It supports Modbus TCP and Modbus RTU by default, and additional communication protocols can be configured according to project requirements, with a library of device drivers covering most inverter and BESS models on the market.

8. The PPC Integration Process, Step by Step

PPC integration runs from the first grid connection study to the end of the plant’s operating life. The five stages below apply to most utility-scale and large C&I multi-asset projects in Europe; their exact content depends on the country and the connecting operator.

1. Grid Connection Studies and Simulation Models

Before connection, the operator assesses how the plant will behave on its network. Many operators require validated dynamic simulation models (for example in PSS/E, PowerFactory or PSCAD formats) that represent the inverters, the BESS and the PPC control logic. The PPC supplier should provide models and parameters consistent with the settings that will be deployed on site, as discrepancies between model and field behaviour are a common source of delay at certification.

2. Design, Configuration and Factory Acceptance Testing

Once the architecture is fixed, the PPC is configured for the site: device list, communication maps, control modes, setpoint ramps and limits. A factory acceptance test (FAT), ideally with hardware-in-the-loop or simulated assets, verifies the control logic and the operator interface before shipping. Issues found at FAT cost a fraction of those found on site.

3. Site Commissioning and Remote Support

Site acceptance testing (SAT) checks communications with every asset, measurement accuracy at the point of connection, and the response to local and remote setpoints. ePowerControl PPC supports local configuration and monitoring through eConf, without requiring persistent internet connectivity on site, and remote monitoring through ePowerMonitor or compatible third-party platforms. Elum Energy provides engineering assistance during design and commissioning, including on-site support according to project requirements, and the Elum Academy certified installer programme trains field teams on controller installation and configuration.

4. Grid-Code Compliance Testing and Certification

The plant must then demonstrate compliance to the operator: active power ramps, frequency response, reactive power and voltage control, setpoint tracking and communication with the control centre. Depending on the country, this involves on-site tests witnessed by the operator, test reports, certification by an accredited body, or staged operational notifications, as in Spain. Settings documentation and test reports prepared by the PPC supplier directly determine how quickly this stage closes.

5. Post-Commissioning: Firmware and Grid-Code Updates

A PPC is a long-term infrastructure component. Your supplier must commit to firmware updates, driver support for new asset types, and corrective maintenance over the full duration of your PPA or operating agreement. With NC RfG 2.0 and national grid codes evolving, settings and functions may need updating several times over a 20 to 25-year life, and every new asset added to the site requires a driver and a re-validation of plant behaviour.

Elum Energy offers tiered support plans with remote assistance packs for commissioning, custom driver updates for new device types, and online corrective maintenance.

Choosing the right supplier for each of these stages is a decision in its own right: see our guide How to Choose a Power Plant Controller Supplier for the full evaluation criteria.

Inspection d’une armoire de contrôle énergétique

9. Real-World PPC Integration Examples in Europe

Elum Energy has deployed NTS 2.1-compliant PPC solutions for utility-scale solar plants in Spain and grid-code-compliant PPC and SCADA systems for 11 MWp solar projects in France. These deployments demonstrate the controller’s ability to adapt to market-specific regulatory requirements while maintaining consistent control performance.

For C&I applications, PV+BESS control systems in Italy illustrate how the same platform manages self-consumption optimisation and grid compliance for smaller-scale hybrid installations.

Beyond Europe, ePowerControl PPC is also deployed on grid-tied utility-scale projects in sub-Saharan Africa and the Indian Ocean region.

10. Common Pitfalls in PPC Integration Projects

Below are four common pitfalls that can derail PPC integration projects for multi-asset energy sites in Europe.

Deferring Control Architecture Decisions

Postponing the selection and specification of PPC, EMS, and SCADA systems until the EPC procurement phase creates scope overlap and integration risk. As noted by Kiwa PI Berlin, this can result in duplication of control hardware and increased CAPEX. Define your control architecture during the early development stage.

Assuming Grid-Code Compliance Is Transferable Between Countries

A controller certified for one European market does not automatically comply with another. National grid codes differ significantly in their reactive power requirements, frequency response specifications, and communication protocol mandates. Verify compliance capability for each specific market where you plan to deploy.

Underestimating Communication Protocol Complexity

Multi-asset sites may need to support multiple communication protocols simultaneously. If your PPC only supports Modbus, you may face challenges when your TSO mandates IEC 61850 for substation-level communication. Ensure your controller supports all protocols required by the relevant grid operator.

Planning Only Up to Commissioning

Many projects plan the PPC up to commissioning day and stop there. Yet a PPC that lacks firmware update support, new device driver development, or corrective maintenance becomes a liability over a 20 to 25-year project lifecycle, especially as grid codes change. Budget and contract for the post-commissioning phase before finalising procurement.

Conclusion: How to Approach PPC Integration in Europe in 2026

Power plant controller integration for multi-asset energy systems in Europe is a strategic decision that directly affects grid-code compliance, operational efficiency, and long-term return on investment. In 2026, proposed changes to NC RfG may affect future requirements for storage and grid-forming capabilities. Project teams should verify which rules are in force for each connection before specifying the PPC .

Define your control architecture early, check the requirements of each national operator, treat integration as a five-stage process rather than a commissioning event, and make sure your controller can be updated over the full life of the plant.

For a technical breakdown of how Elum Energy’s PPC solutions manage grid compliance in different interconnection scenarios, visit the Elum Energy PPC product page.

FAQs about Power Plant Controller Integration in Europe

What is a power plant controller used for in hybrid energy systems?

A power plant controller (PPC) coordinates supported plant assets so that the facility can follow active and reactive power objectives at the point of connection. ePowerControl PPC is designed for utility-scale applications to coordinate generation and storage assets on a site, translating TSO or DSO setpoints into real-time instructions for inverters, BESS, and generators.

Can a single PPC manage both solar and BESS assets?

A single PPC can manage solar PV, BESS, and generators on one site when configured correctly. Elum Energy’s ePowerControl platform is designed to coordinate multi-asset sites, handling dispatch, curtailment, and reactive power management under a unified control architecture.

How long does PPC integration and commissioning take?

It depends on the size of the plant, the number of asset types and the connecting operator. Configuration and FAT typically take a few weeks; on-site commissioning a few days to a few weeks; compliance testing and certification can extend over several months after first energisation in markets with staged procedures. Starting simulation models and settings documentation early is the most effective way to shorten the overall timeline.

Is a PPC mandatory for grid connection in Europe?

EU rules do not mandate a specific device called a PPC. Regulation (EU) 2016/631 sets connection requirements by module category. In Continental Europe, 1 MW, 50 MW and 75 MW are maximum limits for the national capacity thresholds used to distinguish Types B, C and D; national thresholds may be lower, and a connection at 110 kV or above is classified as Type D. Whether a project needs plant-level control depends on the applicable requirements and connection design; a PPC is one way to provide that control.

What is the difference between a PPC and an EMS?

The PPC executes real-time control at the point of connection to meet grid-code and operator requirements, typically within seconds. The EMS works on a longer horizon: it optimises energy flows, schedules and market participation, then sends targets that the PPC executes within grid constraints. On smaller sites, both functions can run on the same platform.

Can an existing solar plant be retrofitted with a PPC to add storage?

Yes. Retrofits usually rely on a hierarchical architecture: a BESS controller runs under a plant-level controller that aggregates both the existing PV and the new storage. The main checks are the compatibility of existing inverters and their communication interfaces, the connection agreement (which may need an update once storage is added), and new compliance tests for the modified plant.
