How to Choose a Power Plant Controller Supplier: 2026 Criteria for European Projects

Table of Contents

The power plant controller (PPC) helps a solar, storage or hybrid plant operate as one coordinated system at the point of connection. The plant will depend on a coordinated control solution throughout its operating life, even if hardware or software components need to be updated or replaced. Choosing the supplier is therefore less about the hardware than about the partner who will keep the plant compliant as assets, grid codes and operating strategies change.

This guide sets out six criteria to evaluate a PPC supplier for projects in Europe, the questions to ask in a request for proposal (RFP), and the warning signs to watch for. For the integration process itself, from grid studies to certification, see our guide Power Plant Controller Integration in Europe: 2026 Guide for Multi-Asset Sites.

schemas

1. Key Takeaways

  • Select the PPC supplier during project development, not at EPC procurement: late decisions create scope overlap and can add around 3% to project CAPEX.
  • Interoperability with the exact assets on your site matters more than the length of a protocol list.
  • A grid-code track record must be proven country by country, with references and test reports, not claimed in general terms.
  • Commissioning support and long-term updates are part of the product. The NC RfG 2.0 proposal could change requirements during a plant’s lifetime, but its final scope and timing are not yet settled.
  • Ask for evidence (driver lists, certification files, support contracts), not promises.

2. When Should You Select Your PPC Supplier?

Many projects leave the PPC to the EPC contractor or bundle it with the BESS supply. This often leads to two suppliers each including a controller in their scope, with unclear boundaries between EMS, PPC and SCADA. According to a 2026 analysis by Kiwa PI Berlin reported by ESS News, postponing control architecture decisions can increase project CAPEX by around 3%.

The right moment to shortlist PPC suppliers is during development, once the connection point and main asset types are known. This is when the supplier can still shape the control architecture, provide inputs for grid connection studies and help write a specification that avoids duplicated scope.

The six criteria below cover what a PPC supplier must bring over the full project lifecycle, from design to the last year of operation.

1. Asset Compatibility and Interoperability

The controller must be compatible with the inverters, PCS units, meters, BESS racks and generators already specified for your project. A controller that cannot communicate with a given model may require driver configuration, custom development or a gateway, depending on the device and interface, which extends commissioning timelines and increases risk.

Two interfaces should be assessed separately. Downstream, towards the assets, Modbus TCP, Modbus RTU and SunSpec Modbus remain the most common protocols. Upstream, the protocol and data model are specified by the connecting operator or connection agreement, sometimes through a substation RTU or qualified gateway. Common protocols include IEC 61850 and IEC 60870-5-104; some projects may use DNP3. Check that the supplier covers both, natively or through a qualified gateway.

Ask for the list of drivers already deployed in the field for your exact asset models and firmware versions. A vendor-agnostic architecture can reduce supplier lock-in, provided that the specific equipment, firmware and interfaces have been tested and validated.

2. Grid-Code Compliance Track Record in Your Target Markets

A PPC and plant configuration demonstrated to meet requirements in one market does not establish compliance in another. Reactive power capability, voltage control modes, frequency response and communication requirements differ between Germany (VDE-AR-N 4110 and 4120), France (RTE and Enedis referentials), Spain (NTS 2.1), Italy (CEI 0-16) and other markets.

Ask each supplier for plants they have taken through compliance in your target countries, with the connecting operator, the voltage level and the certification route. In markets that require plant certification or validated simulation models, check that the supplier can provide models consistent with the settings deployed on site.

3. Scalability and Architecture Flexibility

Scalability should be assessed against your project architecture, not as an abstract capacity figure: number of connected devices, required control functions, interfaces and future extensions. The key question is whether the same platform can handle your next project, or the extension of this one, without a change of system.

Architecture flexibility matters as much as size. For greenfield hybrid plants, a single centralised PPC is often the simplest option. For brownfield projects adding storage to an existing solar plant, the supplier must be able to work in a hierarchical configuration, with a BESS controller under a plant-level controller, and integrate with existing equipment.

4. BESS Integration and Dispatch Logic

On hybrid sites, the PPC must coordinate battery charge and discharge with solar generation, grid setpoints and load profiles, while respecting PCS limits, state of charge and degradation constraints. Ask how the supplier handles functions such as peak shaving, self-consumption optimisation and grid services, and where the boundary lies between the PPC and the EMS in their proposal.

For C&I sites, the business case can be significant: demand charges can represent 30 to 70 percent of a commercial electricity bill, so a controller that reliably caps peak demand has a direct financial impact. The July 2026 NC RfG 2.0 draft also proposes grid-forming provisions for electricity storage modules. For storage projects, ask how the supplier will assess and support these requirements if they are adopted; the final scope and timing may change.

5. Commissioning and Remote Support

Fast, well-documented commissioning reduces project risk and brings forward revenue. Evaluate what the supplier provides at each step: factory acceptance testing, on-site commissioning, compliance test support, settings documentation and test reports.

Check that the controller can be configured and monitored locally, without persistent internet connectivity on site, and that secure remote access is available for support. Training is another lever: a supplier who trains your field teams or your installer reduces your dependence on its own engineers for routine interventions.

6. Lifecycle Support, Firmware and Grid-Code Updates

A PPC is long-term infrastructure. Ask what support period the supplier can contractually guarantee, including firmware updates, driver support and corrective maintenance. This criterion is becoming more important: the July 2026 NC RfG 2.0 draft proposes a nine-month deadline for submitting certain national requirements, methods and parameters under Article 7(6), followed by a separate approval period. The proposal is still under review, so its final wording and timeline may change.

Look at the support model in detail: response times, what is included in the base contract, how new drivers are priced, and what transition plan applies if the supplier stops supporting a product line. Over 20 to 25 years, these terms weigh more than the initial price difference between two offers.

4. Questions to Ask in Your PPC RFP

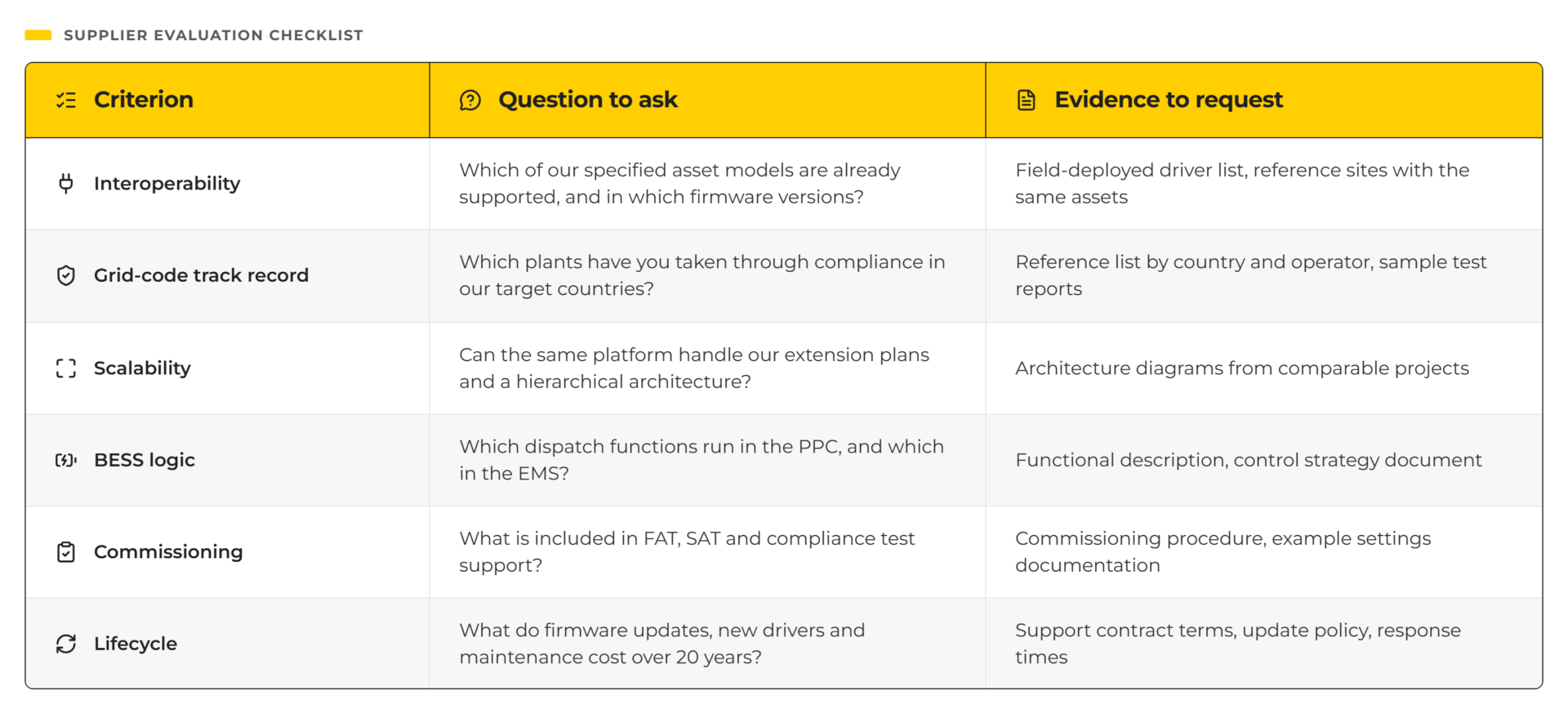

The table below turns the six criteria into questions you can include in an RFP, with the evidence to request for each.

tab

5. Red Flags When Comparing PPC Suppliers

A few warning signs should prompt further questions before you sign.

  • Long protocol lists but no field references with your specific asset models.
  • General claims of grid-code compliance without country-specific references or test reports.
  • No clear answer on who provides simulation models for grid connection studies.
  • A support offer limited to the warranty period, or update costs left undefined.
  • A scope that overlaps with the EMS or SCADA already provided by the EPC or BESS supplier.

6. How Elum Energy Addresses These Criteria

Elum Energy‘s ePowerControl PPC provides multi-brand interoperability with a large number of plant devices. It supports Modbus TCP and Modbus RTU by default, and additional communication protocols can be configured according to project requirements.

ePowerControl PPC has been deployed on grid-tied utility-scale projects in France, Spain, sub-Saharan Africa and the Indian Ocean region. References include NTS 2.1-compliant PPC solutions for utility-scale solar plants in Spain, grid-code-compliant PPC and SCADA systems for 11 MWp solar projects in France, and PV+BESS control systems for C&I sites in Italy.

For commissioning and operation, ePowerControl PPC supports local configuration and monitoring through eConf, remote monitoring through ePowerMonitor or compatible third-party platforms, and optional monitoring and control through ePowerSCADA or third-party SCADA. Elum Energy provides engineering assistance during design and commissioning, including on-site support according to project requirements, and the Elum Academy certified installer programme trains field teams on installation and configuration.

Over the plant’s life, Elum Energy offers tiered support plans with remote assistance packs, custom driver updates for new device types, and online corrective maintenance.

7. Conclusion: Choose a Partner for the Plant's Whole Life

Choosing a power plant controller supplier is a long-term decision. The best offer is not the one with the longest feature list, but the one that proves it works with your assets, has taken plants through compliance in your markets, and commits to keeping the plant compliant as grid codes change.

Start the selection during development, use the six criteria and RFP questions above to compare offers on evidence, and look at the full lifecycle cost rather than the initial price. To see how ePowerControl PPC fits your project, visit the Elum Energy PPC product page.

8. FAQs about Choosing a Power Plant Controller Supplier

How much does a power plant controller cost?

Costs depend on plant size, number of assets, required functions and the scope of SCADA and services included. As an order of magnitude, a 2026 analysis by Kiwa PI Berlin reported PPC and SCADA packages costing between €300,000 and €600,000, depending on functionality. Lifecycle support should be priced and compared alongside the initial investment.

Should the PPC come from the inverter or BESS manufacturer, or from an independent supplier?

A manufacturer’s controller can be a good fit on single-brand sites. On multi-asset sites mixing brands, or where assets may change over the plant’s life, an independent, vendor-agnostic supplier reduces lock-in and simplifies the coordination of all assets under one control strategy.

Can the EPC contractor provide the PPC?

Yes, but the owner should still define the control architecture and specify the PPC requirements, so that the EPC and BESS supplier do not each include overlapping controllers. The owner should also secure the lifecycle support terms directly, since the EPC’s involvement usually ends after handover.

How long does it take to select a PPC supplier?

For a utility-scale project, allow enough time for a structured RFP, technical clarifications and reference checks before the specification is frozen. Starting during development, rather than at EPC procurement, gives time to compare offers on evidence without delaying the project.

Sources

Kiwa PI Berlin analysis, reported in: ESS News, “Delayed BESS control decisions can raise project CAPEX”, 22 June 2026. https://www.ess-news.com/2026/06/22/delayed-bess-control-decisions-can-raise-project-capex/
